CASE STUDY
Building in Bali
In this examination of a three-bedroom upscale villa located in Tumbak Bayuh, which was finalized in June 2023, we will present a comprehensive overview of the essential phases involved in property development in Bali. If you are considering a purchase in Bali, our Villa Teyseddou case study can serve as a valuable resource to enhance your understanding of the construction process.
Our case study serves as an informative guide to elucidate the intricacies of building in Bali. The specific duration of each project may vary depending on factors such as size and budget.
We sourced land in Tumbak Bayuh, which is a fast growing area for residential property. We work directly with our expert partners to source land that has beautiful greenery views.
LAND
PURCHASE
March 2022
We clear the land of any unwanted shrubs so that we have a blank canvas to work with.
LAND
Clearance
March 2022
We conduct a soil test to assess ground conditions so that we know how deep to build our footings. We then conduct the topography survey to assess the shape and contours of the land.
Topo Survey & Soil Test
March 2022
We will ask for your ‘mood board’, where you show us all of the design ideas you like. Then, our architects will generate expertly crafted drawings and blueprints tailored to your specifications and the topography of your property.
ARCHITECTURAL
DESIGN & DRAWING
MARCH - May 2022
We dig down and pour our concrete footings reinforced with steel.
Footings
June 2022
We use reinforced concrete with steel to ensure maximum strength. We also build the foundation higher than the ground to avoid any future issues with flooding.
FOundation
July 2022
Our slab is prepared by reinforcing the structure with steel and then pouring concrete. Before we pour, we use a damp proof membrane and also spray for termites.

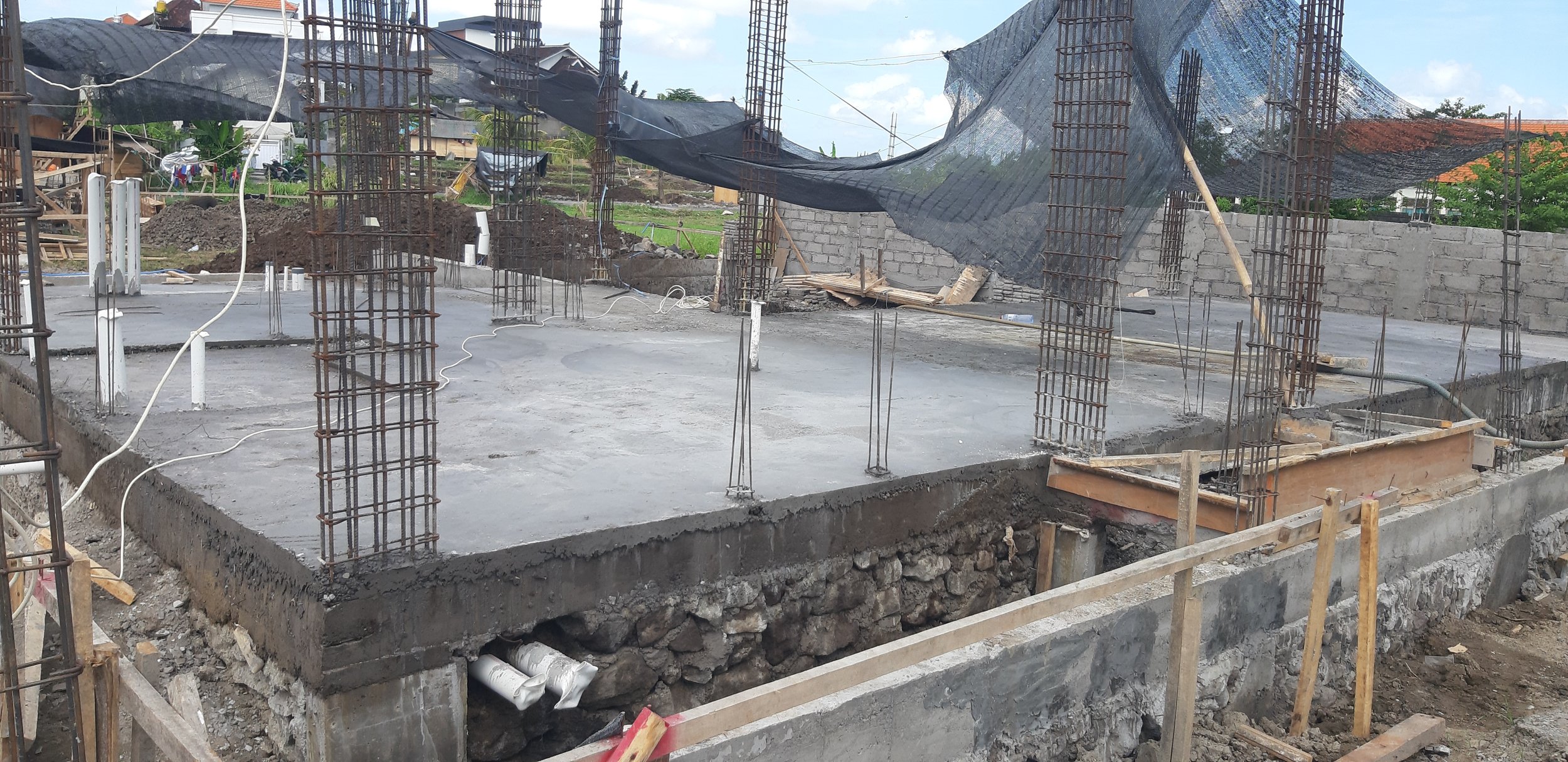

Ground floor slab
August - september 2022

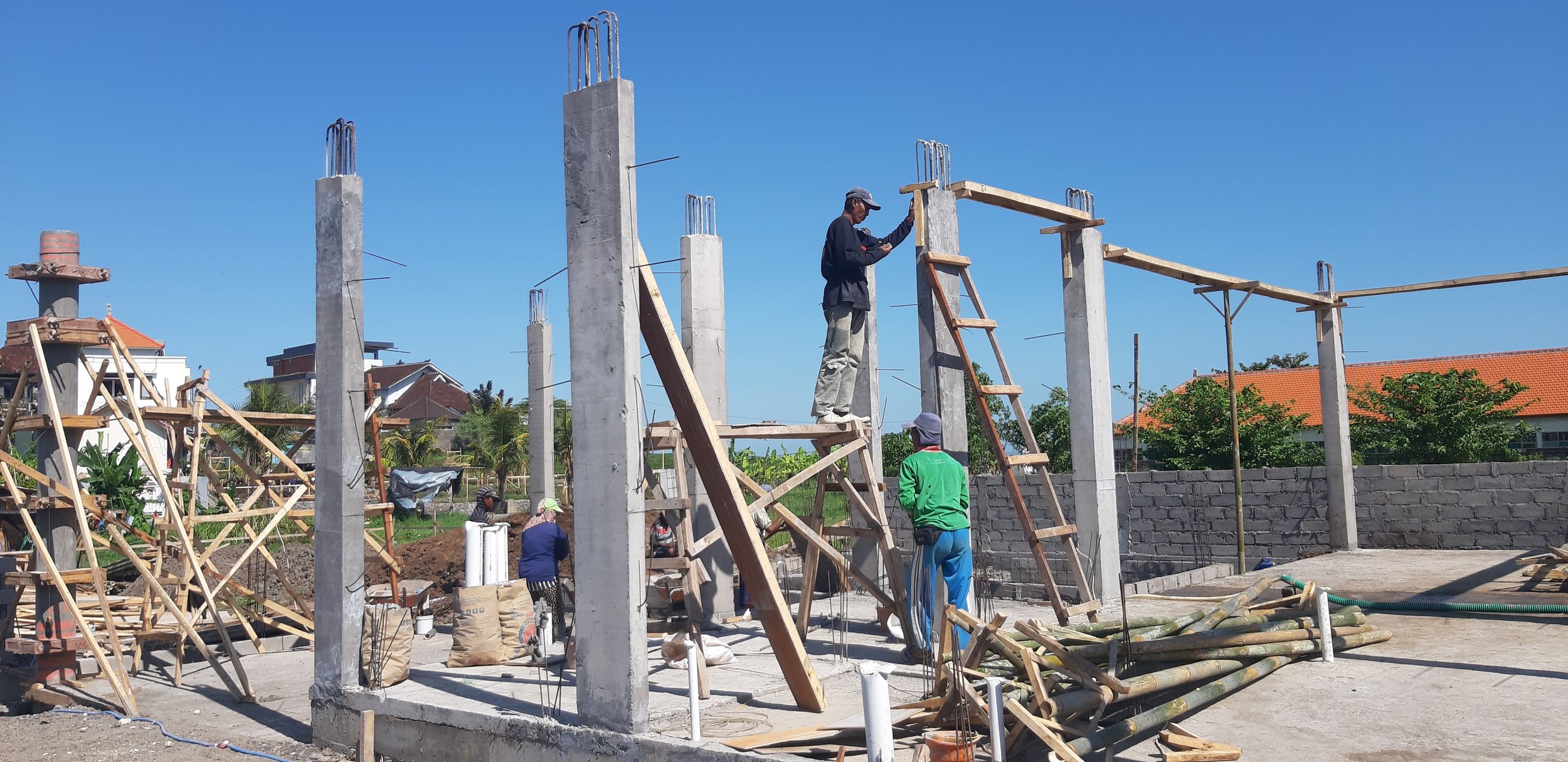

Our concrete columns hold up the second floor of the building.
Concrete Columns
september 2022
Again we reinforce the first floor concrete slab with high gauge steel before pouring. All plumbing is also built in here.
First floor slab
september - october 2022
The pool, pump room, and balancing tank are constructed using reinforced concrete and premium waterproofing membranes for superior durability.
POOL, Roof & Top floor
CONSTRUCTION
october - December 2022
December - February 2023
INTERIOR
structure
All interior structural work is carried out such as stairs, window openings, interior walls etc.
December - February 2023
Exterior
structure
All exterior structural work is carried out such as pool tiling, planter boxes.
The interior finishing is carried out, alongside the services such as electrics and plumbing.
Interior finishing
February 2023 - april 2023
The exterior finishing is carried out, working closely with the architectural plans.
Exterior finishing
February 2023 - april 2023
The villa has its final finishing. Where all hard furniture is installed such as kitchen, bathroom, built in cupboards.
Final finishing
May 2023
Our villas come with free interior design, so we will pre order your furniture as per our 3D renders, all ready for you to move in.
FURNITURE
jUne 2023
The villa is handover is met, and the villa build is complete.
Completion & handover
june 2023
Our optional villa management services make it easy to rent your property to short term holidaymakers in Bali.
We take care of everything from guest check in, marketing, bookings, channel management, cleaning, taxes & more.
We charge a commision based fee, so you only pay us from what you earn. We expect to reach over 90% occupancy on our villas, and with the very best construction and design, the nightly price is maximised.
VILLA
MANAGEMENT
June 2023 onwards
When embarking on a construction project in Bali, it is imperative to adhere to the local rules and regulations to maintain legal compliance. Our team is proficient in handling all the necessary legal obligations for your upcoming villa in Bali, ensuring a smooth and lawful process.
